The contractor explained why it was decided to lay the water supply line for Mykolaiv from Nova Odesa: «This is the closest area where drinking water is of good quality»
-
- Yuliia Boichenko
-
•
-
16:27, 11 April, 2025
It was decided to build a new water supply system for Mykolaiv from Nova Odesa, as it is the nearest site «with good quality drinking water».
This was announced by Maxim Shkil, founder of the «Avtostrada» group of companies.

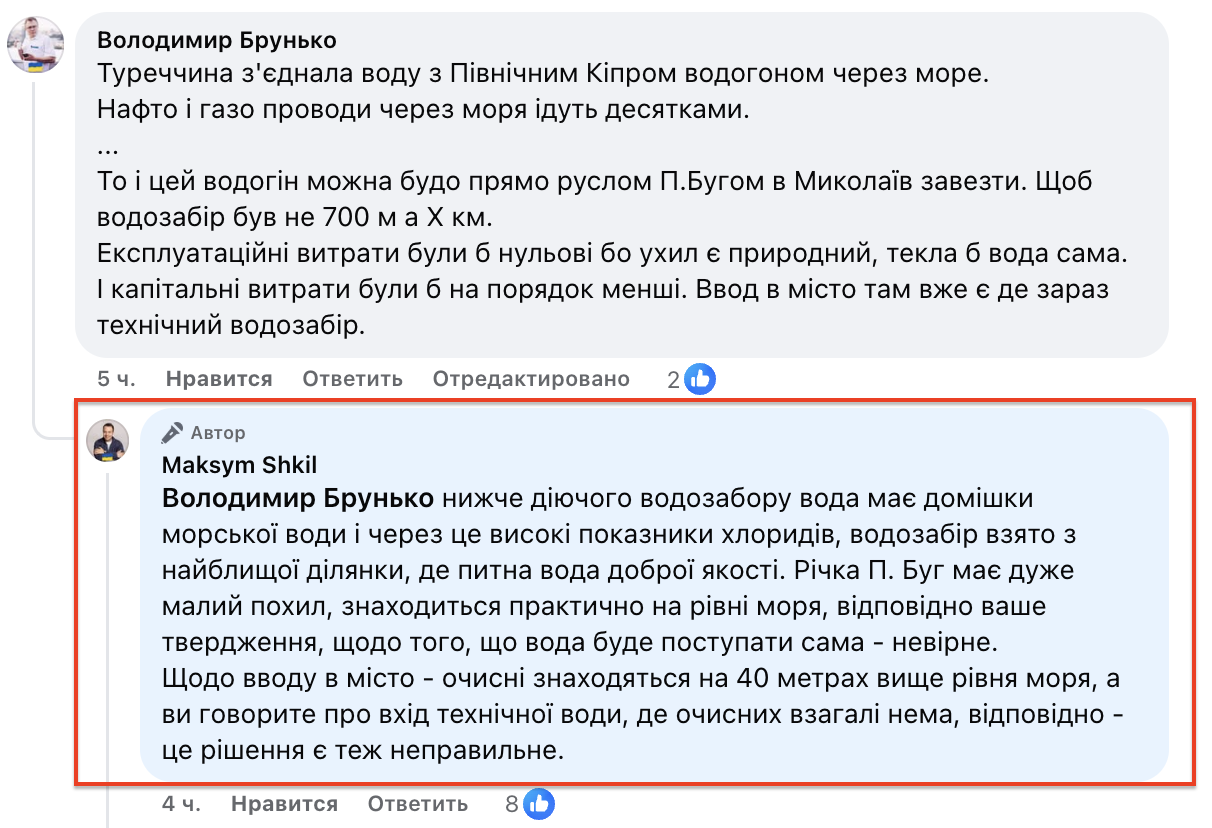

He explained that the water in the Southern Bug River, which is closer to Mykolaiv and below the existing water intake, has sea water impurities and therefore high chloride levels.

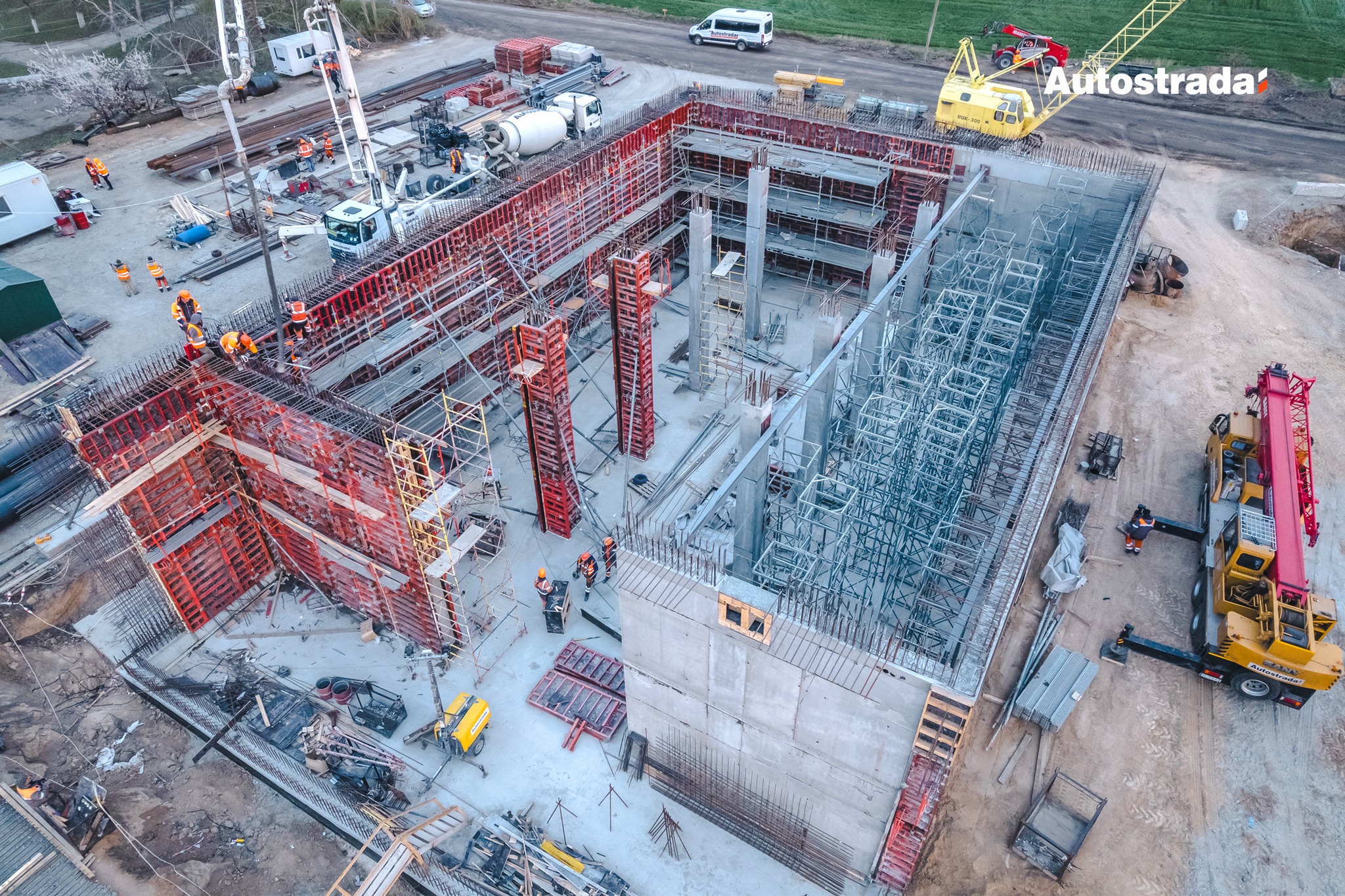

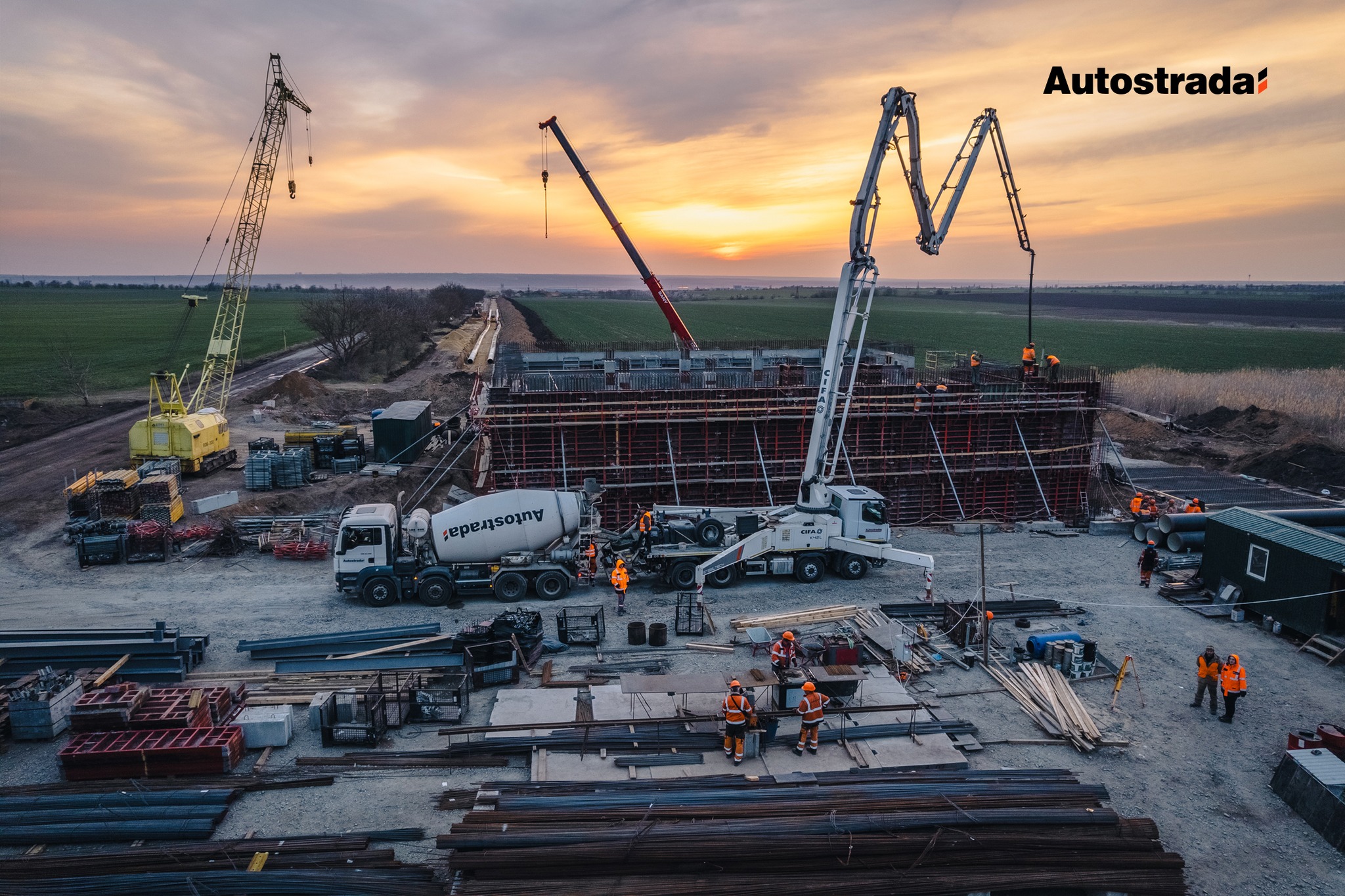

Since March 2025, the construction of a new water supply system for Mykolaiv has been carried out by «Autostrada», said Maksym Shkil.
«More than 1,000 employees, hundreds of units of equipment are involved, we work around the clock,» he added.
According to him, the construction of the water supply system for the city is going to be completed in 5 months — by August 2025.
«This is an absolutely record pace for an infrastructure project of this scale. Despite the fact that the project is complex, it is quite real for the Autostrada team: the Autostrada Design Institute develops technical solutions that the construction units immediately implement. We work on the design&build principle, which ensures full synchronisation of the work of engineers and builders and significantly reduces the lead time. No subcontractors — only internal resources. At the same time, Autostrada's production facilities, including concrete and asphalt plants and laboratory complexes, are operating 24/7 at the water supply system construction site. The quality of materials and work is controlled at every stage of production,» said Maksym Shkil.
He specified that the active phase of work on the first section of the water supply system started in March, and the second and third sections — in April.
«All work is carried out exclusively by Autostrada, without the involvement of subcontractors. This approach ensures full control over the processes, strict adherence to schedules and maximum efficiency in the use of budget resources,» he added.

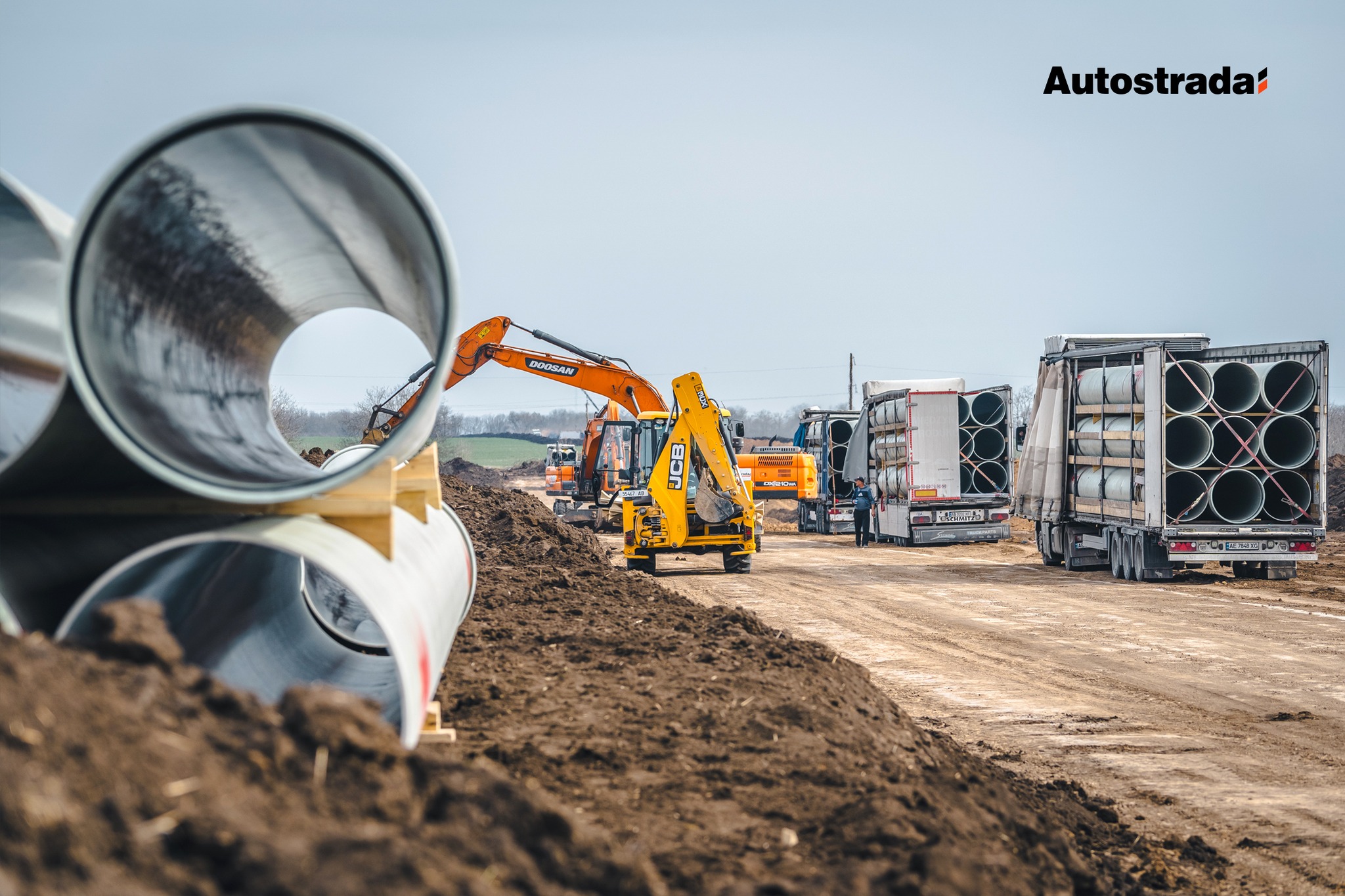

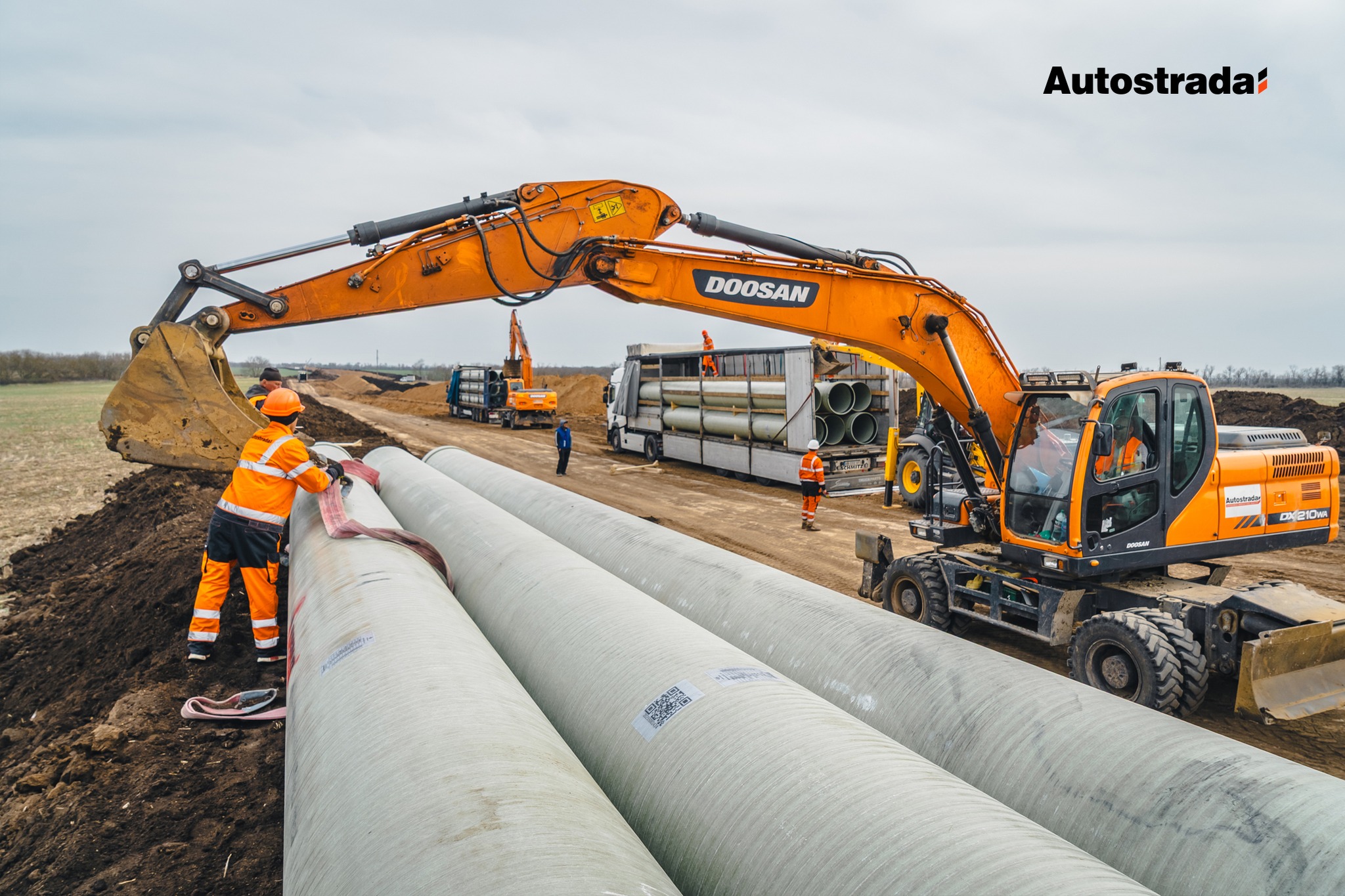

The total cost of the water supply system construction, including additional works, amounted to 6.2 billion hryvnias. The total length of the new water supply network is 67.8 kilometres. Three powerful pumping stations (640-800 kilowatts) are planned along the route to ensure a stable water supply.
The capacity of the water supply system is 120,000 cubic metres per day for Mykolaiv and 50,000 cubic metres for the reclamation system of Nova Odesa and Mykolaiv district.

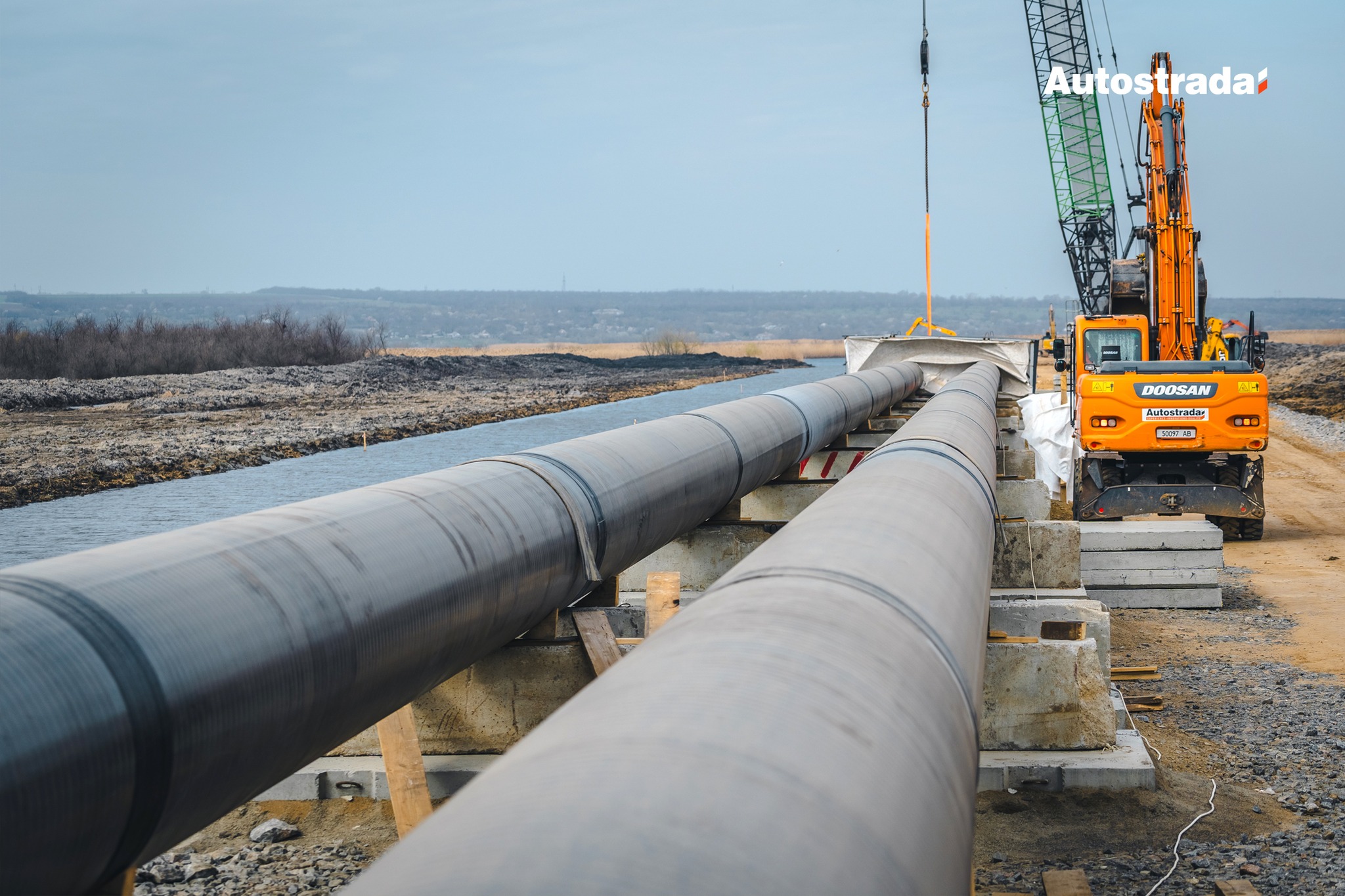

The water supply system for Mykolaiv will work as follows, the contractor explained: water will be taken through four gravity pipes from the Southern Bug River in the area of Nova Odesa, filtered, and then transported through three pumping stations to Mykolaiv's water treatment facilities.
«The route is being laid outside of settlements or along their outskirts, and we are avoiding laying pipelines through city and village streets with a large number of utilities. This approach allows us to preserve the existing infrastructure and complete the work faster and without unnecessary complications for local residents,» said Maksym Shkil.
He also added that all pumping stations and power grids are located in protected areas for safety during shelling.
On 7 April, the Infrastructure Restoration and Development Service in Mykolaiv Oblast cancelled three contracts with contractors that were to build a new water supply system for Mykolaiv. The respective additional agreements on the termination of contracts were signed with the companies «Avtostrada», «Ukrtransmist» and «Rostdorstroy».
